How to Qualify for Construction Loan in 2026

Most construction-loan advice starts with the wrong formula: good credit plus a large down payment equals approval. That formula describes only the borrower's financial profile. A construction lender is underwriting an unfinished asset, a builder's ability to deliver it, a budget that can change during the work, and a repayment plan that still has to function if the project takes longer than expected.

That's why learning how to qualify for construction loan financing requires more than checking a credit-score box. In the Southeast, a deal can look strong on paper and still fail because the contractor has no verifiable completion history, the draw schedule doesn't match the payment obligations, or the budget leaves no room for soft costs and carrying expenses. The practical question isn't merely whether you can borrow. It's whether the lender can understand, monitor, and recover the capital through every stage of the build.

Why Most Construction Loan Guides Get Qualification Wrong

A 720 credit score won't rescue a poorly scoped project. A borrower with substantial liquidity can still be declined if the builder can't document completed work, the plans aren't sufficiently developed, or the completed value doesn't support the requested loan. Construction lending treats the borrower and the project as one underwriting package, not as separate approvals.

For a lender, the collateral is incomplete until construction finishes. Funds leave the lender over time, while the property's value depends on the borrower's ability to execute the approved scope. That creates a different risk profile from stabilized real-estate debt. An FDIC working paper reported mean construction-loan loss-given-default of 56.7%, with a median of 62.4%, which helps explain why lenders examine sponsor experience, contractor quality, and budget realism so closely (FDIC construction-loan loss research).

The deal is the application

Underwriting usually connects four questions:

  • Can the borrower contribute and carry the project? The lender reviews credit, available equity, liquidity, repayment capacity, and the source of any additional capital.
  • Can the builder execute? The lender wants evidence of completed projects, licensing or registration where required, insurance, references, and financial stability.
  • Does the project make economic sense? Plans, permits, site conditions, contractor pricing, completed value, and contingency planning must fit together.
  • What's the exit? A sale, refinance, or permanent loan must be realistic for the completed asset and the intended market.

A first-time builder with clean personal finances often struggles because the lender can't verify execution capacity. The concern isn't personal character. It's the absence of evidence that the sponsor can manage subcontractors, inspections, change orders, payment timing, and unexpected site conditions.

Southeast execution exposes weak files quickly

A ground-up project in Georgia may have a credible acquisition basis but an incomplete permit path. A North Carolina build may have attractive resale assumptions but a contractor budget that excludes important site or utility work. In South Carolina and Texas, the same underwriting concern applies even when local costs and approval processes differ. The lender needs a complete, internally consistent file rather than a promising concept.

Practical rule: If the builder, budget, draw process, and exit strategy don't tell the same story, the lender will assume the project is less controlled than the borrower claims.

Borrowers can reduce confusion by organizing plans, budgets, contractor credentials, and property information in a clean presentation package. A tool that helps agents and investors create professional realtor PDFs can also support a more readable lender package, provided the underlying information is accurate and complete.

The Underwriting Criteria That Determine Approval

Construction lenders judge the request through loan-to-cost, or LTC, and loan-to-completed-value, or CLTV. LTC compares the proposed loan with total project cost. CLTV compares the loan with the expected value after completion. A project may have a sound cost basis and still fail if the finished value does not support the requested debt.

The lender verifies land basis, contractor pricing, materials, soft costs, financing expenses, contingency, and the completed appraisal. Equity must cover the gap between the approved loan and the total capital required, including room for overruns. Bank construction lending research has reported an average CLTV of 75.36%, a benchmark that helps explain why borrowers may need meaningful cash or subordinated capital (FDIC-linked construction lending study).

What lenders test before approving draws

Underwriting usually follows this sequence:

  1. Establish total cost. Separate land, hard costs, professional fees, permits, utilities, insurance, financing expenses, and contingency.
  2. Confirm the completed value. Review the plans, market support, and appraisal for the finished property.
  3. Run LTC and CLTV. Keep the request within the lender's limits and provide enough equity to absorb gaps.
  4. Stress-test execution. Examine whether the builder, timeline, budget, and reserves can withstand changes.
  5. Approve the draw structure. Match funding releases to completed work, inspections, invoices, and the borrower's payment obligations.

The fifth step often determines whether an otherwise acceptable deal can close. A budget may be reasonable, yet a draw schedule that releases funds after the builder must pay subcontractors can create a liquidity problem. The lender wants the construction sequence, borrower cash flow, inspection timing, and payment obligations to agree before the first advance.

Personal income still matters, especially for bank and consumer-oriented programs. Investor-focused lenders may assign greater weight to collateral, project feasibility, liquidity, sponsor execution, and the planned exit. The evidence changes by capital source, but scrutiny remains.

Construction loan qualification benchmarks

Criteria Conventional Bank FHA Construction Private or Hard Money
Credit profile Many borrowers typically need around 680 credit, with stronger credit improving flexibility Financing can allow 580 credit with 3.5% down, or 500 credit with 10% down, although lender overlays may be stricter Requirements vary, with greater emphasis often placed on project viability, collateral, builder quality, and liquidity
Equity Commonly around 20% to 25% down for many U.S. construction loans Lower required equity may be available under program rules, subject to lender approval and overlays Structure depends on capital structure, completed value, project risk, sponsor strength, and exit
Core underwriting Income, credit, equity, plans, builder, appraisal, LTC, and CLTV Program eligibility, borrower qualification, approved project documentation, and lender requirements Asset value, cost basis, execution plan, builder, liquidity, and repayment strategy
Funding process Milestone-based draws with inspections and documentation Milestone-based draws subject to program and lender procedures Draws aligned to agreed project milestones, inspections, and supporting records

Before submitting, run the deal through the lender's likely decision points. A structured real estate underwriting framework helps organize cost, value, capital, draw timing, and exit assumptions into a file an underwriter can review efficiently. A clean file cannot fix weak economics, but it exposes the core issue early and prevents avoidable delays.

Builder Experience and Track Record Requirements

The builder bottleneck is the qualification issue most casual guides understate. Lenders aren't financing blueprints alone. They're financing a person or company that must turn those blueprints into a completed, insurable, marketable property.

A professional infographic outlining builder experience and track record requirements for construction projects with a house in the background.

What experience means to an underwriter

Approved-builder status, completed project history, liquidity reserves, and references can matter as much as the borrower's credit profile. Lender-facing guidance commonly clusters around 680-plus FICO, 20% or more down, and reserves, while more selective programs may look for 700-plus credit, six months of interest reserves, and prior completed builds.

Those figures are not universal approval rules. They're signals of how lenders separate a straightforward file from a higher-touch one. A contractor's portfolio should show relevant residential work, not merely unrelated construction activity. The lender may ask for addresses, completion dates, budgets, final inspections, references, and evidence that prior projects closed without unresolved disputes.

A builder working in Georgia should be ready to document the credentials and project history required in that market. The same principle applies in North Carolina, South Carolina, and Texas. Local familiarity helps, but it doesn't replace evidence.

How newer builders can reduce the concern

First-time builders shouldn't try to hide the experience gap. They should compensate for it with structure:

  • Bring in an experienced construction partner. A qualified general contractor or co-sponsor can provide execution history that the new sponsor doesn't yet have.
  • Use a fixed, detailed scope. Plans, specifications, allowances, and change-order procedures should leave limited room for ambiguity.
  • Show reserve capacity. Liquidity should cover more than the planned equity contribution if the project needs additional support.
  • Provide independent validation. Architect, engineer, inspector, and appraisal documentation can make the project easier to monitor.
  • Choose a manageable first project. A simpler scope with a credible budget is easier to defend than an ambitious build with untested assumptions.

Self-employed investors face a similar misconception. The question isn't always whether they have a traditional wage history. It's whether they can demonstrate the ability to complete the project and carry costs if the timeline changes. A strong deal can receive a more constructive review when the sponsor presents the builder, budget, reserves, and exit as a coordinated operating plan.

Your Complete Documentation Checklist

A lender should be able to answer three questions from the file without repeatedly requesting basic information: what will be built, what it will cost, and how the debt will be repaid. Missing documents don't always kill a deal, but they slow underwriting and create doubt about project control.

Borrower and sponsor records

Prepare a concise financial file before requesting terms:

  • Credit and identity information: Include authorization details and explanations for material credit events.
  • Liquidity evidence: Provide current statements showing the source of equity, reserves, and any subordinated capital.
  • Experience summary: List completed projects, property addresses, original scope, completion status, and outcomes.
  • Entity documents: Include formation records, ownership information, operating agreements, and signing authority.
  • Repayment explanation: Describe the sale, refinance, or permanent financing strategy and identify the assumptions behind it.

Banks may request traditional income documentation. Asset-focused lenders may emphasize property and project strength instead, but they still need a clear picture of the sponsor's obligations and available capital.

Project and builder records

Your project package should include the final or near-final plans, specifications, site information, construction contract, itemized budget, timeline, permit status, and completed-value support. The builder file should contain license or registration information where applicable, insurance, references, portfolio evidence, and a clear description of who controls the work.

The budget deserves special attention. Separate hard costs from soft costs, and identify professional fees, permits, inspections, utilities, insurance, financing expenses, and interest reserves. A contingency line should be visible rather than buried inside a contractor's lump-sum estimate.

Land, title, and exit evidence

Include the purchase contract or settlement statement for the land, survey information, title details, zoning or entitlement records, environmental material where relevant, and any easements that affect construction. If the land is already owned, document the basis and current ownership clearly.

For the exit, provide a realistic refinance or sale analysis. If the plan depends on a future permanent loan, make sure the completed property is likely to meet that lender's requirements. If the plan depends on sale, support the marketability of the finished product without overstating the expected price.

File test: An underwriter should be able to trace every major budget item to a plan, a contract, a permit, or a supporting estimate.

State and local requirements vary across Georgia, North Carolina, South Carolina, and Texas. Confirm the applicable licensing, permitting, insurance, lien, and inspection requirements early, then preserve the records for every funding milestone.

How Draw Schedules Work and Why They Affect Qualification

A construction loan isn't released as a lump sum. The lender advances money in stages after verifying that the corresponding work has been completed. That makes the draw schedule part of qualification, not merely an administrative detail.

Consider a ground-up residential build where the contractor needs deposits for materials before the next visible milestone is complete. If the approved schedule only funds after installation, the borrower may face a payment gap even though the project is proceeding according to plan. Conversely, if the budget assigns too much money to an early stage, the lender may see a mismatch between funds advanced and measurable value created.

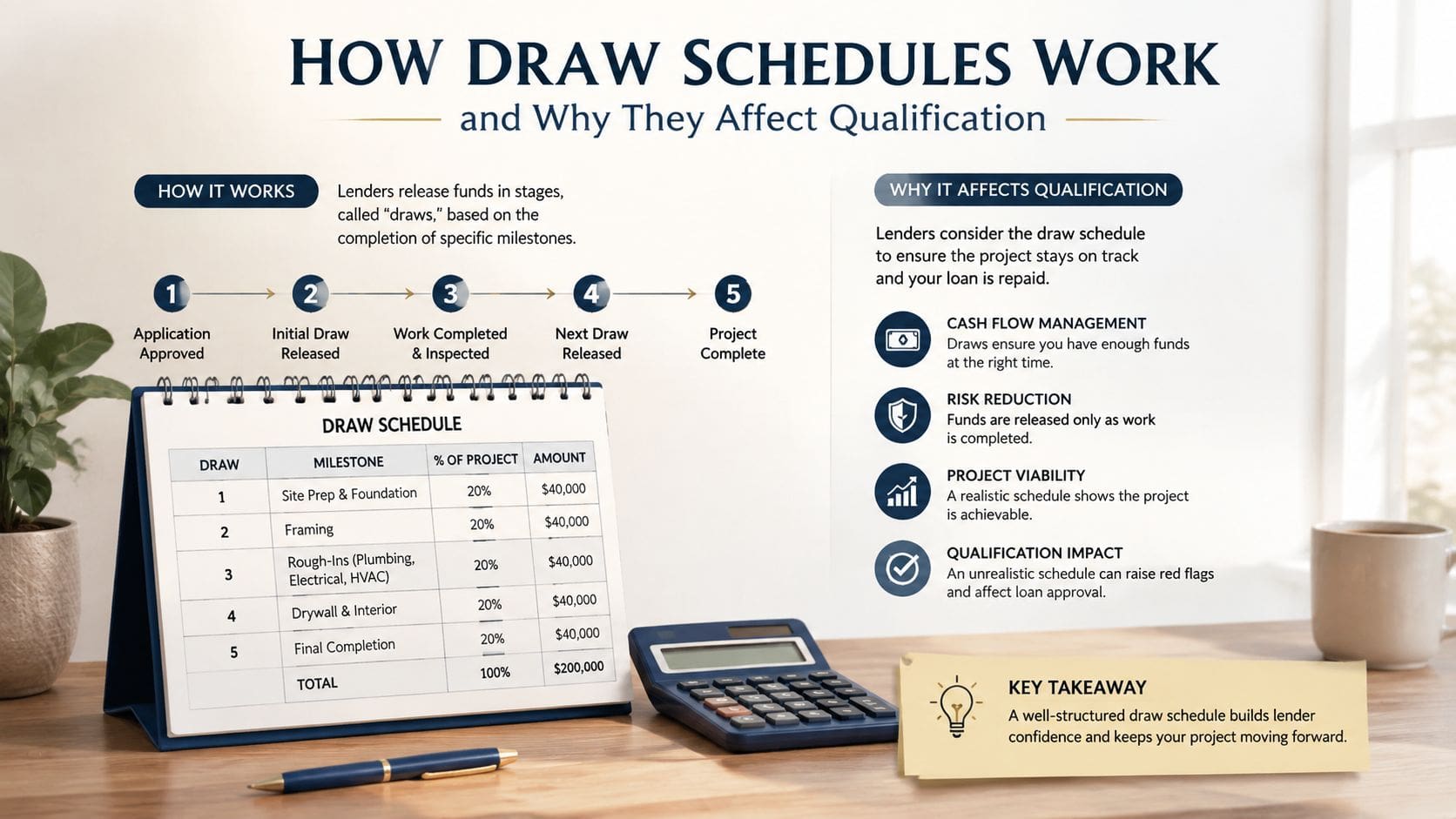

A visual guide explaining how construction draw schedules work and their impact on loan qualification processes.

What happens at each draw

The borrower submits a request tied to an approved milestone. A third-party inspector then verifies the percentage of work completed before the lender releases funds. The package generally needs current invoices, permits or inspection records, lien waivers, photographs or completion evidence, and documentation for approved scope changes.

Inspection fees can add roughly $150 to $350 per draw for residential projects (FDIC construction-loan loss research). The borrower should include that expense in the project budget rather than treating it as an unexpected closing-period charge.

Why draw discipline protects approval

Suppose a builder changes window specifications, moves a plumbing wall, or discovers additional site work. The borrower should document the change, identify the cost impact, and obtain approval before the work disrupts the budget. A lender may tolerate a reasonable change. It won't respond well to an undocumented change that appears after funds have already been spent.

Interest reserves also matter because the project carries debt before producing a sale or stabilized rental income. A borrower who budgets only visible construction expenses may still run short while paying interest, insurance, taxes, utilities, and professional fees.

A well-built construction draw schedule aligns the contractor's payment needs with inspection points and the lender's release procedures. That alignment helps the lender forecast exposure and helps the builder avoid financing the job personally between milestones.

How 2026 Lending Conditions Are Changing Your Qualification Odds

Qualification odds depend on lender appetite, not only on your file. A borrower can meet a bank's published criteria and still face a difficult process if the institution is reducing construction exposure, limiting exceptions, or reserving capacity for existing relationships. In 2026, the first question is often whether the lender is actively deploying into your project type.

Recent market data shows a tighter bank channel. Construction and development loan balances fell to $456.3 billion in Q4 2025, down 5.7% year over year, while total outstanding acquisition, development, and construction loans stood at $469.1 billion in Q2 2025, down 5.3% year over year. These figures describe market supply, not an individual borrower's approval odds. They do explain why banks may apply stricter builder requirements, limit exceptions, or take longer to approve a construction request.

The bank channel is not the whole market

Residential construction is moving differently from the broader channel. One-to-four-family construction balances reached $91.2 billion in Q3 2025, the first annual increase in more than two years. That improvement does not mean every bank is pursuing every residential builder. Capital remains uneven across lender type, geography, asset profile, and sponsor quality.

Investor-driven lenders represented 30% of all construction loans in the first half of 2025. For borrowers in Georgia, North Carolina, South Carolina, and Texas, that creates a practical financing choice. A bank may offer a lower headline cost while requiring extensive income documentation, a longer approval process, and a builder with an established record. Private capital may place greater weight on collateral, completed value, execution capacity, liquidity, and the exit, usually at a higher cost of capital.

Private capital can be more accessible for self-employed investors, complex ownership structures, newer sponsors with an experienced partner, or time-sensitive acquisitions. It does not correct weak project economics. The lender still needs a credible budget, debt structure, builder, draw schedule, and repayment plan.

Your qualification odds change with the capital source. Repeated applications to lenders that are inactive in your market or mismatched to your asset can make a viable deal look weaker. Capital availability depends on lender type, geography, asset profile, and sponsor quality as lending conditions shift.

Practical Tips to Improve Your Approval Odds

Start preparing before you have a property under contract. Clean up unresolved credit explanations, document available liquidity, interview builders, and build a repeatable project package. The strongest applications don't begin with a lender form. They begin with a budget and execution plan that have already been challenged.

Before submission

Select the builder before finalizing the financing request. Obtain the contractor agreement, insurance, license or registration records, references, project history, and a realistic construction schedule. Ask the builder to identify long-lead materials, site risks, subcontractor dependencies, and items that commonly produce change orders.

Build the budget in layers. Include land, hard costs, soft costs, permits, professional fees, inspections, insurance, interest carry, and contingency. Then compare the requested loan with both total cost and completed value. If the financial structure only works under an optimistic appraisal or an aggressive resale assumption, fix the structure before underwriting finds the problem.

In the weeks before closing

Keep the file consistent. The plans, appraisal, contractor budget, draw schedule, purchase agreement, and entity documents should use the same property description and scope. Explain every material assumption, especially where the land basis, borrower contribution, or exit depends on another transaction.

Use construction loan preapproval to test the borrower and project profile before committing to a final build scope. Preapproval isn't a substitute for full underwriting, but it can reveal whether the proposed financing, builder, and capital source fit together.

Choose capital deliberately

A conventional bank may suit a straightforward project with a documented builder, strong borrower profile, flexible timing, and a preference for lower pricing. Private financing may make more sense when speed, asset-based analysis, a complicated income profile, or a nonstandard project structure matters more than the lowest rate.

Sims Ventures offers ground-up residential construction financing for investors and builders in Georgia, North Carolina, South Carolina, and Texas, with draws aligned to project milestones and deal-focused underwriting. Visit Sims Ventures to discuss your construction plan, documentation, and exit strategy with a lender that evaluates the complete project rather than credit score alone.
